Agile vs. Waterfall Hybrid Method

The deadlock in between Agile and Waterfall procedures has actually continued job management discourse for years. Software application advancement groups flourish in Agile environments, however an absence of management assistance is among the significant barriers to Agile improvement A job supervisor operating in the software application market for any length of time has actually most likely experienced a C-suite that desires them to “do Waterfall.” However exactly what does that mean in practice?

For several years, research studies have actually revealed a favorable relationship in between using Nimble structures and job success, and it might be appealing for a job supervisor to think they simply require to offer their business officers on Agile’s outcomes. However it’s similarly crucial to comprehend what upper management likes about the Waterfall approach If you comprehend the monetary safeguards that Waterfall pays for the C-suite, you can craft a hybrid structure that will bridge the space in between Nimble practices and business Waterfall at last. The start of that understanding depends on Waterfall’s primarily unknown origin story.

The Dirty Origins of Waterfall Method

Many people in organizational management associate the term “Waterfall” with the chart below, which originates from “ Handling the Advancement of Big Software Application Systems,” a prominent scholastic paper composed by Winston W. Royce, PhD, in 1970. Royce’s illustration is extensively credited as the very first expression of Waterfall advancement.

The Waterfall model, a series of steps from System Requirements, Software Requirements, Analysis, Program Design, Coding, Testing, to Operations.

The crediting of Waterfall advancement to Royce’s research study is among the weird paradoxes of the software application market. In his paper, Royce never ever utilizes the word “waterfall” or promotes it as an efficient system; he really provides what would become referred to as Waterfall as a cautionary tale– an example of a procedure that is “dangerous and welcomes failure” since it does not represent the essential model required amongst software application advancement phases.

Royce was not alone: 18 years later on, Barry W. Boehm, PhD (who would quickly end up being director of DARPA), utilized a really comparable illustration, once again as an example of a troublesome software application advancement life process, and proposed iterative advancement as a beneficial option. In 1996, practically the whole software application market backed an iterative advancement cycle called the Logical Unified Process (RUP), which was itself a synthesis of finest practices widely acknowledged by software application engineers.

This raises a huge concern: Why would anybody in management push back versus using Agile over Waterfall, a structure that because its creation has been seen by market specialists and experts to be at chances with effective advancement practices?

OpEx vs. CapEx: The Financial Case for Waterfall

The factor Waterfall stays in favor needs a little understanding about an organization function that advancement groups hardly ever think of: accounting.

In double-entry accounting, there are 2 sort of costs: functional costs and capital spending (likewise typically described as OpEx and CapEx). Any cost reduces the net earnings of a business, however a functional cost– such as lease, payroll, or insurance coverage– reduces it more The cash is invested, and is for that reason no longer on the books. A capital spending– such as property, factory devices, or workplace furnishings– reduces earnings less since of an accounting method called devaluation, which disperses the cost over a number of years. Likewise, as soon as a possession has actually been bought, it is thought about part of the business’s net worth.

In Between 2000 and 2002– even as the Agile Manifesto was being established– the business world was rocked by a set of significant accounting scandals, beginning with the United States energy business Enron Simply put, Enron (with the supposed complicity of accounting company Arthur Andersen) hid significant losses from financiers by deliberately mishandling functional costs and capital spending. This became part of a bigger plan to fraudulently inflate its earnings, and for that reason enhance its stock exchange worth, by billions of dollars.

Soon afterwards, a comparable scandal took place at United States telecoms business WorldCom. WorldCom likewise concealed losses by actively miscategorizing functional costs as capital spending, and the 2002 session of Congress responded by passing the Sarbanes-Oxley Act Consisted of in this expense’s arrangements were brand-new guidelines that made business officers, such as the CEO and CFO, personally accountable for investor losses that took place since of an absence of due diligence.

When it concerns software application advancement, CapEx versus OpEx is a specifically intricate problem: CapEx looks great on a balance sheet, enabling business to report a much better operating earnings and obtain bigger amounts.The drawback, nevertheless, is that capitalization requirements have actually developed and need paperwork, evaluations, and approvals– all of which can significantly prevent the software application advancement procedure.

This is where job management plays a main function. In the wake of this legislation, CFOs required a security system that they might indicate: a management design that might show they had actually fulfilled the requirements of the Sarbanes-Oxley Act. The Task Management Institute had a service: the phase-gate procedure (likewise referred to as stage-gate). This Waterfall method utilizes a series of “gates”– stops briefly where executive approval would be required for advancement to advance. By specifying a phase which contained just CapEx-eligible activity, and separating it from all other phases, CFOs might show that they had actually worked out due diligence when noting an expense as a capital spending.

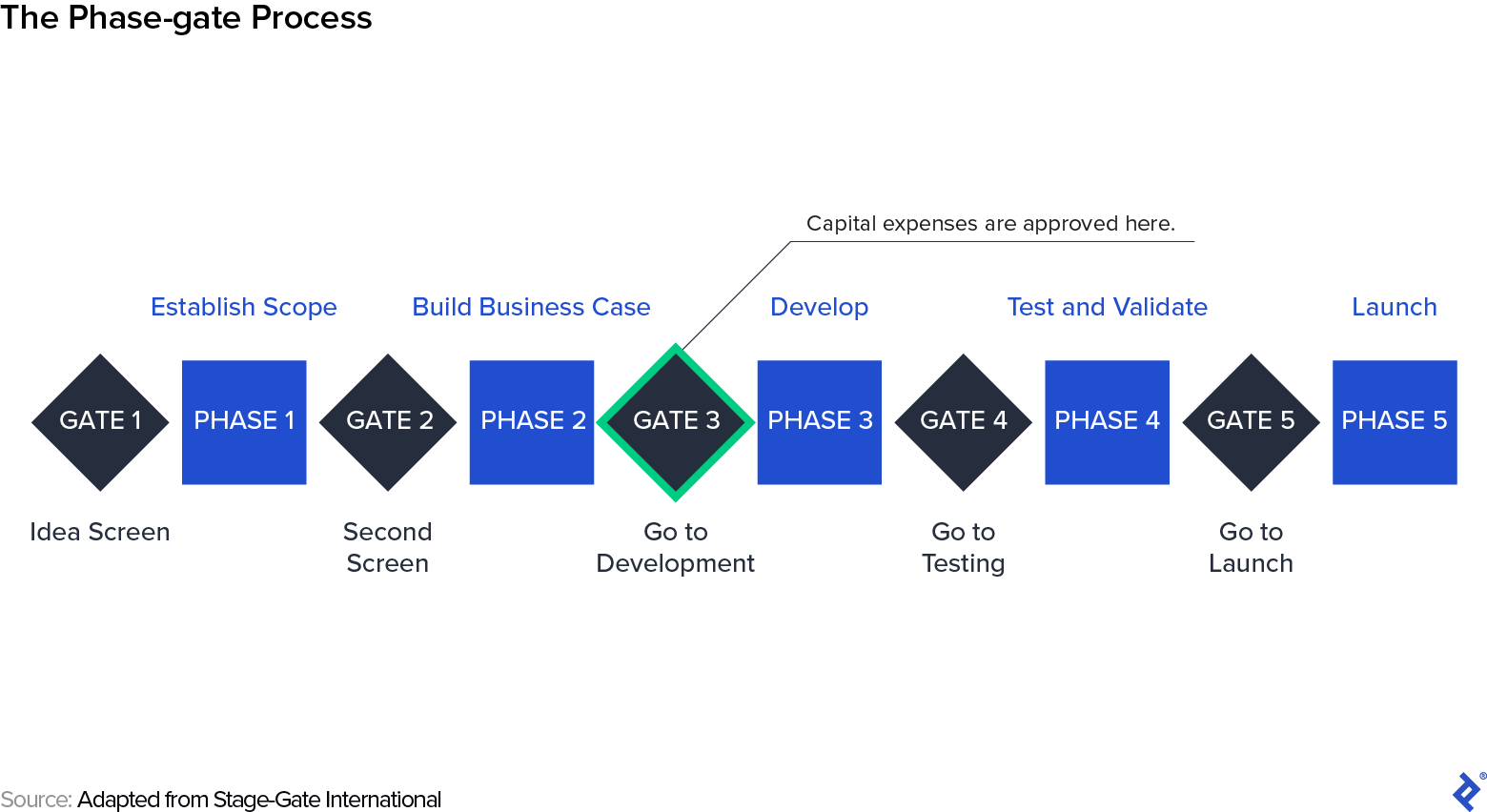

The phase-gate process: Establish Scope, Build Business Case, Develop, Test and Validate, and Launch, and five gates. Gate 3 is for capital expenses.

Fast-forward to today day, and phase-gate management has actually been the de facto requirement for advancement jobs at public business for twenty years– Stage-Gate International approximates that 80% of the Fortune 1000 utilizes some variation of this structure. For a Nimble designer or job supervisor, this might appear confusing. Does not your CFO understand the advantages of Agile? They might or might not, however in either case, the most crucial thing for a job supervisor to keep in mind is: They do not care.

When the CFO desires you to “do Waterfall,” it’s not based upon a belief that Waterfall is the most reliable method to provide software application. It seldom matters to them if developers utilize RUP, Scrum, XP, Crystal, FDD, DSDM, Kanban boards, or any other advancement method or management structure; what they appreciate is capitalizing the job without breaching the regards to the Sarbanes-Oxley Act.

Fortunately is that whatever you require to do to ensure the CFO that the job will pass an audit occurs beyond the real advancement procedure. If you can ensure the C-suite that their requirements will be fulfilled, they ought to be open to a hybrid approach in which monetary issues are dealt with through Waterfall in the preparation phase and advancement is performed in a Nimble structure:

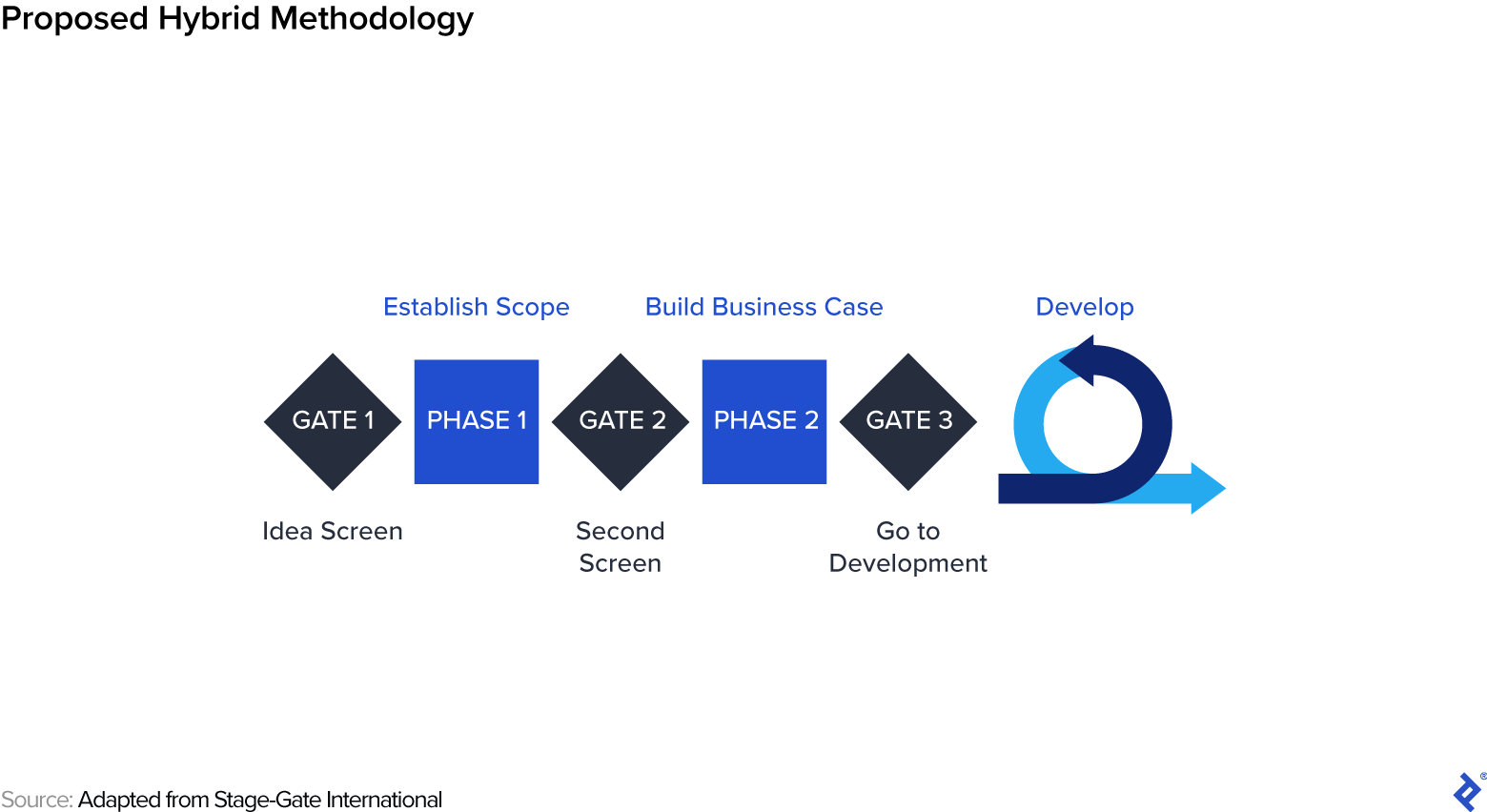

The first three gates and two phases of the phase-gate process, followed by the logo for Agile development.

If a job supervisor comprehends what their CFO desires and can ensure them of the functional oversight offered by a phase-gate structure, there’s no factor to utilize Waterfall over Agile in advancement. Simply approach the requirements of phase-gate management with the understanding that its function is monetary and legal and does not need to affect your group’s advancement work. Here’s how to start:

Deal With Budgeting as Iterative … Up Until It Isn’t

Every year, the business spending plan assigns a set total up to capital investment. One little piece of that is assigned to software application advancement jobs, and magnate work out for the greatest piece possible for their jobs. This settlement procedure typically goes on for the very first 2 or 3 months of the .

Settlement is incredibly iterative, so job budget plans vary continuously throughout this procedure. Empower your organization sponsor by offering them with adjustable price quotes. The objective here is to develop a budget plan envelope, so broad choices for several contingencies will be incredibly useful. For instance, along with a standard price quote, you may offer a more affordable choice that would be practical if cost-saving conditions are fulfilled, like doing information migration through manual entry, or a more pricey choice if additional functions are consisted of, like a mobile app. This will assist your organization sponsor change their spending plan demand as treasury committee settlements get underway.

These price quotes require to be offered ahead of spending plan settlements, since as soon as the treasury committee authorizes the jobs for the year, there is no going back. In the phase-gate system, gate 3 is where the job is provided treasury approval. Versatility in budgeting exists, however just on the front end of the procedure, prior to this gate happens.

Understand Materiality

Your job control workplace (or, if you do not have one, your monetary controller) can assist you comprehend business limits for materiality— the point at which monetary variation is essential enough to be tape-recorded: The purchase of a box of pens might be thought about immaterial, however purchasing brand-new computer systems for the group isn’t. The line where immaterial ends up being product differs by business. Comprehending your business’s limit, and recording appropriately, will endear you to anybody making accounting choices.

Share your domain understanding with your equivalent in financing; for instance, comprehending the idea of switching user stories and reaching agreement on how to manage the practice will prevent the look of impropriety. Guarantee them that if any extra cost from a swap threatens to surpass the materiality limit, you will intensify it so it can be effectively recorded.

Speak the Language of Financing

If you are not currently acquainted with weekly status reports and threat logs, get familiar. Read them. Love them. Fill them out routinely and properly. Provide to your job management workplace and they will like you in turn.

Most significantly, if you offer job spending plan reports or updates, make certain your line product titles and descriptions precisely match the ones you utilized when the spending plan was very first authorized. If the authorized spending plan describes “Legendary: Authentication UI,” then that’s what you ought to place on your report– not “Legendary Login Screen” or any other variation. Disregard this recommendations and you are ensured to develop friction and disappointment throughout the whole monetary arm of the company.

Worth Delivered

If you satisfy the monetary requirements above, congratulations! You’re satisfying the C-suite’s requirement to “do Waterfall.” The capital spending are effectively tape-recorded, and no part of the procedure has actually needed any modification in how code is really composed or how updates are provided. Any compromises you have actually needed to make in preparation have actually gotten you allies in other departments and the C-suite. The procedure has actually likewise provided you a much better understanding of how your group can deal with other parts of the company, instead of toiling in seclusion– or even worse, operating in opposition to those who are expected to be in your corner.

An Nimble perfectionist may think about these monetary issues to be “agreement settlements.” Nevertheless, it’s simply as legitimate to think about your monetary associates as internal organization clients. Fulfilling their requirements on matters of financing is simply another type of consumer cooperation. And in Agile, the consumer’s understanding of worth provided constantly wins.
